Timeline
| Client | Project | Scope | Status |
|---|---|---|---|

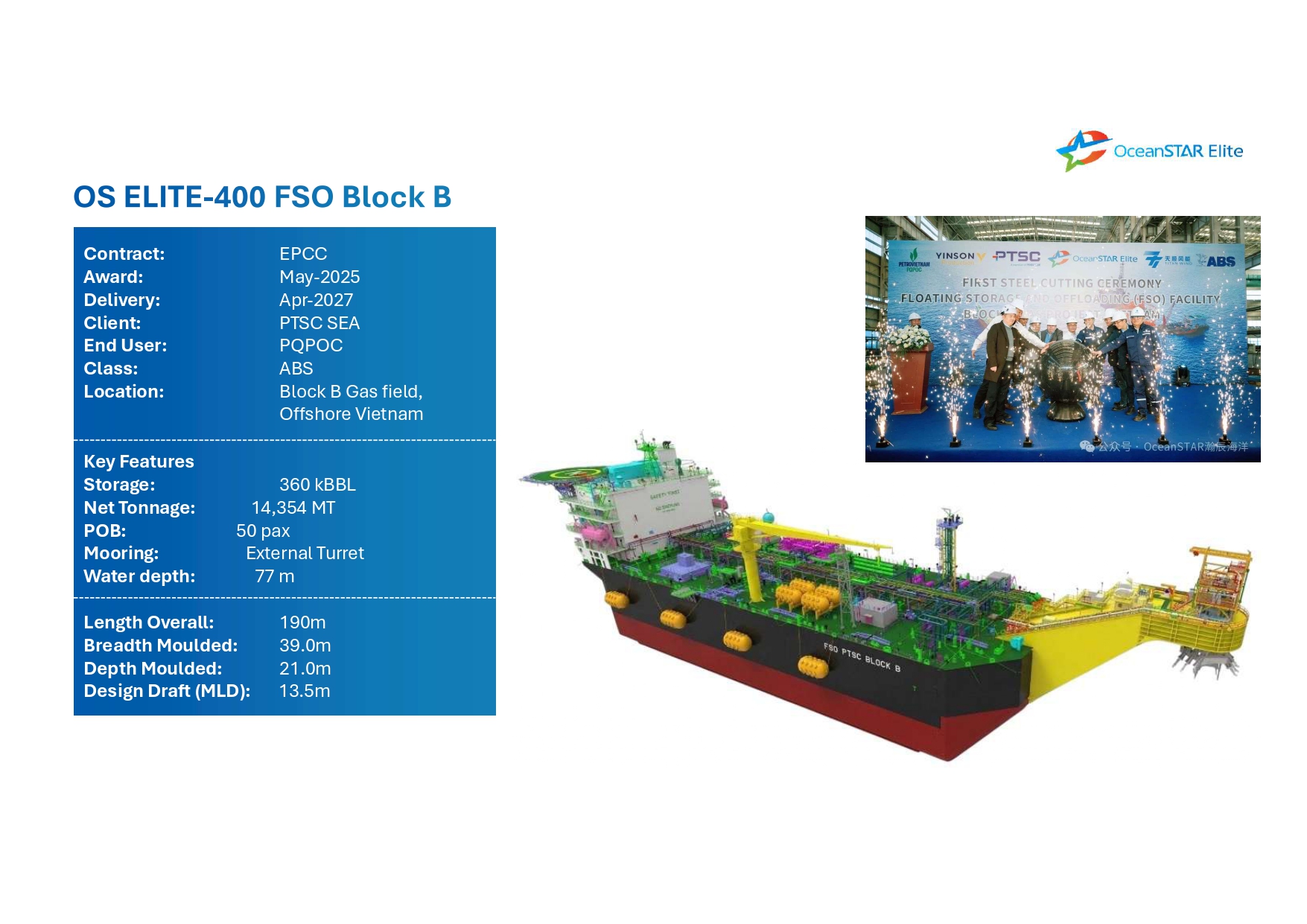

| PTSC | Block B FSO Project Offshore Vietnam | Full EPCC Scopes Full Project Management Full Engineering Design Procurement (LLI, equipment etc.) Digital Development (EPCI management and construction workflow management) Construction Commissioning | Ongoing |

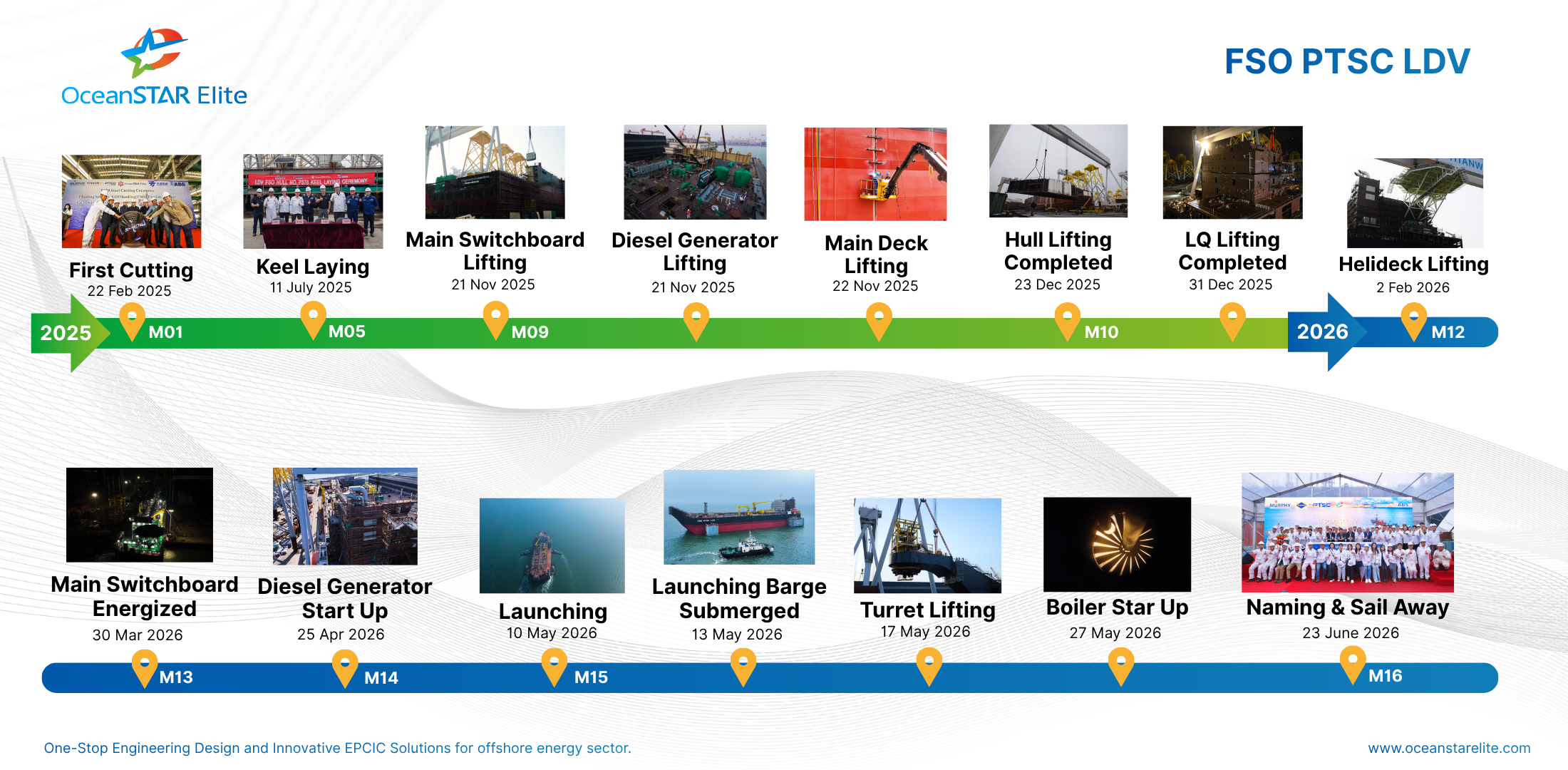

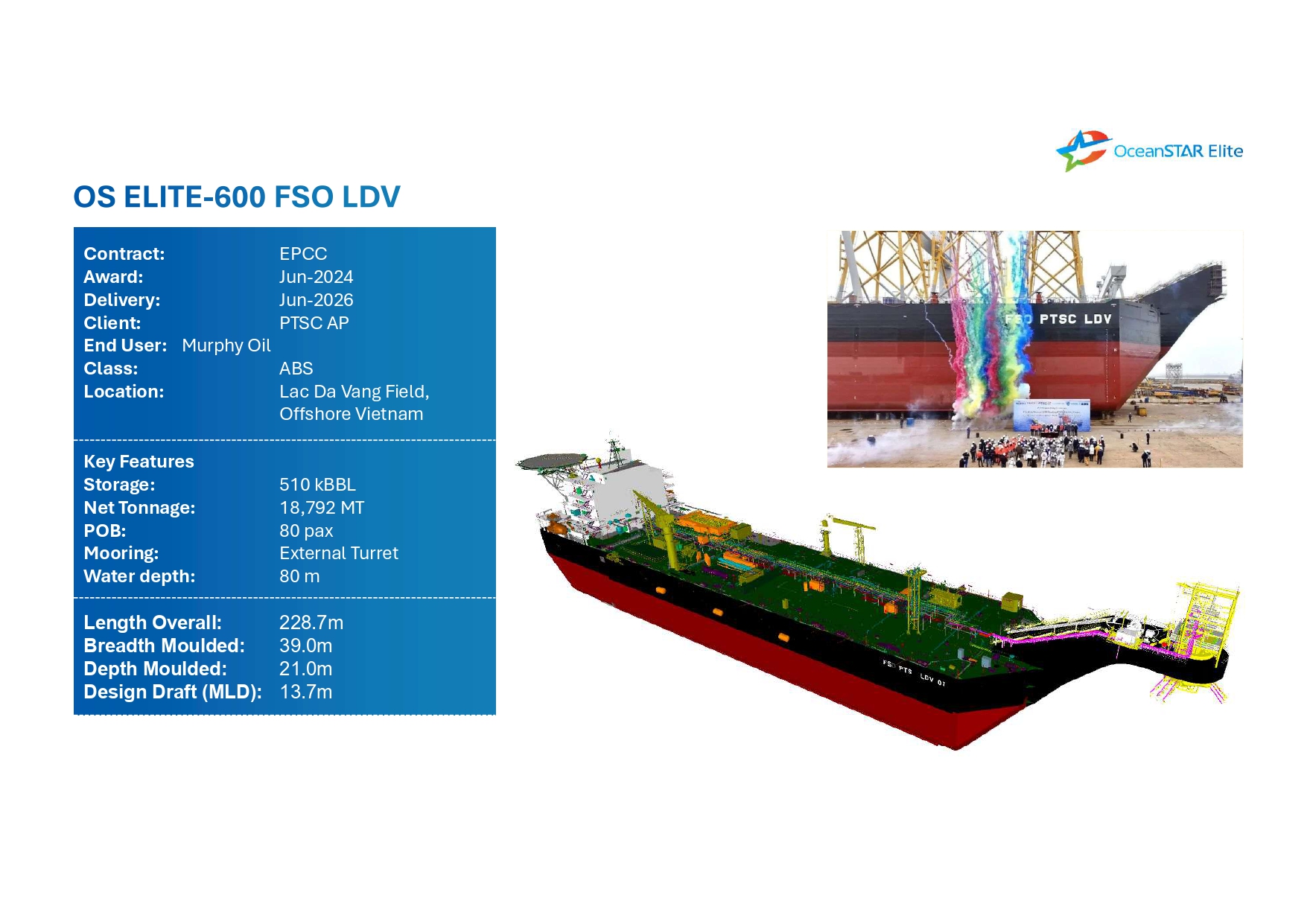

| PTSC | Lac Da Vang (LDV) FSO Project Offshore Vietnam | Full EPCC Scopes Full Project Management Full Engineering Design Procurement (LLI, equipment etc.) Digital Development (EPCI management and construction workflow management) Construction Commissioning | Sail Away on Jun 23rd, 2026 |

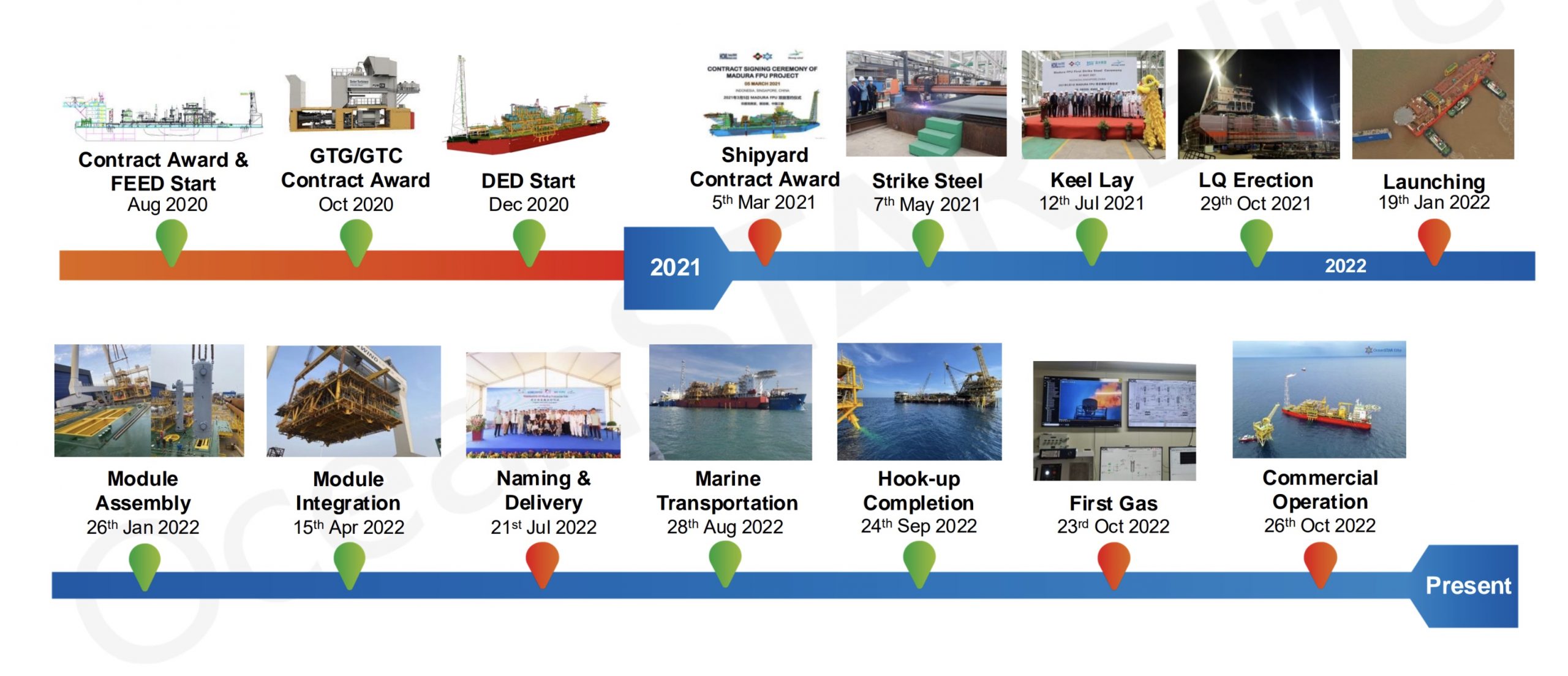

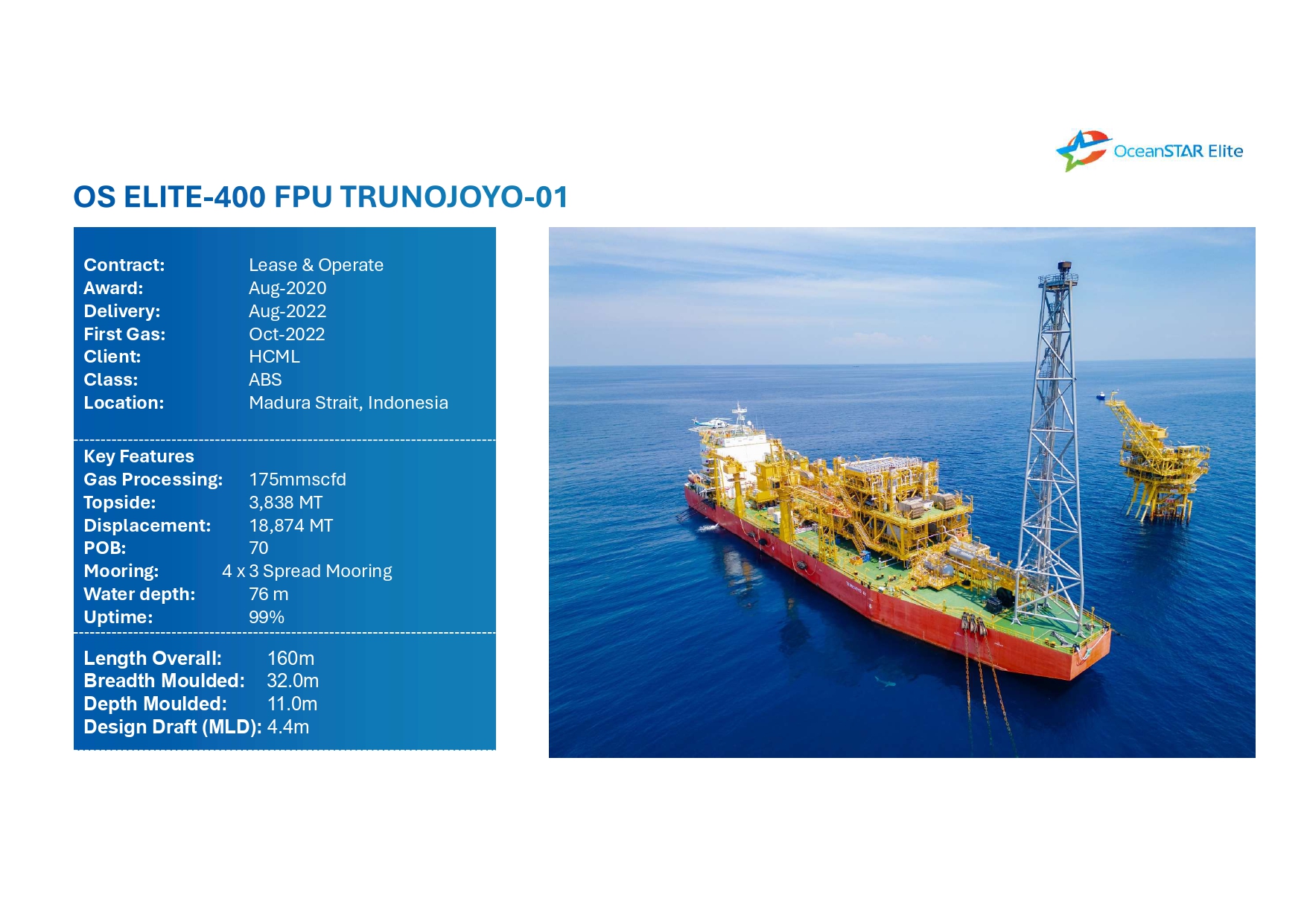

| HCML | FPU Trunojoyo 01 | Full EPCIC Scope The new build FPU with main dimension of 160m LOA, 32m Breadth and 11m Depth will have main facility comprising: Process facility including separation, gas compression, gas dehydration and custody transfer metering system; Utility System including fuel gas system, open-drain and closed-drain, flaring system, lifting cranes, instrument & utility air, seawater, fresh water, potable water, firewater, power generation and electrical system, E-house, control system, telecommunication system, etc; Living Quarter (Accommodation) with capacity of 70 POB for the FPU CONTRACTOR’s operations personnel, including COMPANY’s personnel and occasional short-term stay for offshore maintenance staff; Helideck; Lifesaving & fire-fighting system; Marine system; Spread mooring with 12 studless chain lines and driven anchor pile type supported by chain stoppers; Bunkering/de-bunkering facilities for diesel fuel oil and bunkering facilities for fresh water; Flexible jumpers and umbilical (power cable and fiber optic). | Delivered First Gas on Oct 23rd, 2022 Operating safely and continuously to date |
